Kitchen Remodel Permits in Salisbury, MD: What's Required

If your kitchen remodel in Salisbury changes wiring, plumbing, gas, venting, or walls, you will likely need a permit. Painting, swapping flooring, adding backsplash tile, or replacing cabinets and counters in the same layout usually does not.

  • No permit usually needed: paint, flooring, backsplash, same-layout cabinets, same-location counters, like-for-like appliance swaps
  • Permit usually needed: moving a sink, adding circuits, changing outlets, adding an island outlet, new gas line, exterior-vented hood, removing any wall, changing a window or door opening
  • Where to apply: City addresses go through Salisbury's Department of Infrastructure and Development; homes outside city limits in unincorporated Wicomico County go through county Planning & Zoning
  • Who can apply: the owner, contractor, architect, or engineer
  • What to expect: permit review, rough-in inspections, and final approval before the job is done

Cosmetic work is permit-free. System or layout changes are not.

County review is often listed at 10 to 14 business days. If a contractor pulls the permit, Salisbury requires proof of an active MHIC or Home Builders license. No work should start before the permit is issued.

Confirm the job scope first, then match each part of the work to the right permit type: building, electrical, plumbing, gas, or mechanical. That step helps avoid stop-work orders, failed inspections, and resale problems later.

Kitchen work that usually requires a permit

Salisbury requires a permit for kitchen work that changes the structure or adds new construction. In plain terms, once a project goes beyond surface-level updates, permits usually come into play.

Here’s how that rule applies to common kitchen remodel tasks.

Plumbing, electrical, gas, and venting changes

Moving a sink to another wall requires a plumbing permit. The same goes for adding a dishwasher line, a new water supply line, or new drain lines. If the work reaches under-slab sewer lines, permits and inspections are required, including an underground inspection before concrete is poured.

Electrical work follows the same pattern. Adding dedicated appliance circuits, relocating outlets, or running power to a new island requires an electrical permit. Maryland building code also requires GFCI protection on all kitchen countertop outlets.

A new gas line for a range requires a gas permit. An exterior-vented range hood needs a mechanical permit because it vents to the outside.

Wall, layout, and exterior opening changes

Removing a wall - load-bearing or not - requires a building permit in Salisbury. If the wall is load-bearing, the project also needs engineered drawings, especially when the work involves laminated beams, steel beams, or changes to floor or roof truss layouts.

Changing the footprint of the space can also trigger permit rules. Widening a doorway, changing a window size, or creating a new exterior opening from the kitchen requires a building permit. For this type of work, the city asks for two sets of scaled drawings with floor plans, header and girder sizes, and exterior elevations.

Common kitchen tasks and likely permit type: comparison table

Kitchen Task Permit Required Likely Permit
Sink replacement in the same location No N/A
Moving a sink to a new wall Yes Plumbing
Adding recessed lights (new wiring) Yes Electrical
Adding an island with a power outlet Yes Electrical
Installing a new gas range and line Yes Gas / Plumbing
Exterior-vented range hood Yes Mechanical
Removing a non-load-bearing wall Yes Building
Removing a load-bearing wall Yes (engineering required) Building
Enlarging or moving a window Yes Building

This table is practical guidance, not a substitute for local approval. Confirm permit rules with the Salisbury Department of Infrastructure and Development before work begins.

Next, the key question is who pulls the permit and what inspections follow.

Kitchen work that usually does not require a permit

In Salisbury, permits usually are not needed for nonstructural repairs or cosmetic kitchen updates, as long as you are not changing electrical, plumbing, mechanical, or structural systems. That’s the whole line, plain and simple: cosmetic work is usually fine; system changes are not.

Cabinets, counters, flooring, paint, and backsplash in the same layout

Replacing cabinets and countertops is usually permit-free if the layout stays the same and no plumbing or electrical lines are moved. The same goes for painting, installing backsplash tile, and replacing flooring.

That said, the moment a project moves a sink, outlet, or appliance location, it usually shifts into permit territory. A kitchen can look like a simple facelift on the surface, then turn into permit work fast once the layout starts changing.

Same-location fixture and appliance swaps

Swapping a light fixture in the same location without changing wiring usually does not need a permit. Replacing a refrigerator, electric range, or dishwasher with a similar unit in the same spot also typically does not require one, as long as no new wiring, plumbing, or gas work is involved.

The catch is pretty straightforward. If the new appliance needs a larger circuit, a new circuit, a gas line change, or plumbing changes, a permit is usually required. Same spot does not always mean same scope.

Permit-free work vs. borderline cases: comparison table

Some kitchen jobs look simple but can still trigger code rules once walls, wiring, or pipes get involved. This table shows where common projects usually land and what tends to push them into permit-required work.

Task Usually No Permit Why It May Become Permit-Required
Cabinets Replacing or refacing cabinets in the same footprint Relocating cabinets can require moving electrical outlets to meet current code spacing
Countertops Installing new countertops on the existing footprint Moving the sink or cooktop location requires plumbing or gas line changes
Flooring & Backsplash Replacing flooring or installing a backsplash in the same location Structural repairs, such as work on floor joists, may require a permit
Electrical Swapping a light fixture or outlet cover using existing wiring Adding recessed lighting, moving outlets, or upgrading the electrical panel
Plumbing Replacing a faucet or a like-for-like sink or dishwasher in the same spot Relocating the sink, dishwasher, or adding a new pot-filler line
Appliances Swapping an electric range or dishwasher in the same location Converting from electric to gas, or adding a new dedicated 240V circuit
Ventilation Replacing an existing recirculating range hood Installing a new hood that requires cutting a hole for exterior venting

If the project crosses into system work, the next issue is who pulls the permit and what inspections come after.

Who pulls the permit, how the process works, and what inspections to expect

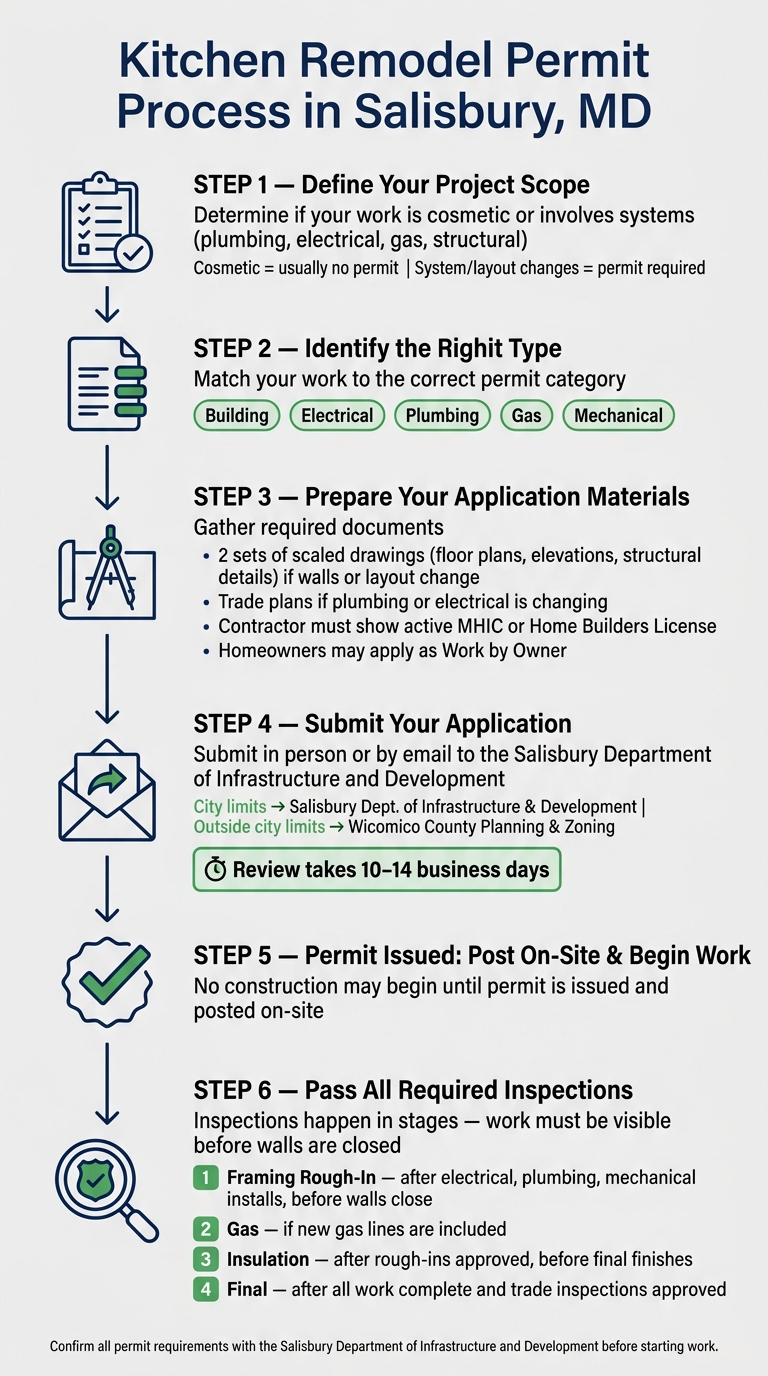

Salisbury, MD Kitchen Remodel Permit Process: Step-by-Step Guide

Salisbury, MD Kitchen Remodel Permit Process: Step-by-Step Guide

Contractor permit responsibility and homeowner permits

When a bathroom remodel moves into building, plumbing, electrical, or gas work, a permit has to be filed before any work starts. The application can be submitted by the owner, contractor, architect, or engineer.

For contractor-led jobs, there’s a firm rule here: the contractor must show proof of an active Maryland Home Improvement Commission (MHIC) or Home Builders License when the application is filed. If a homeowner wants to handle the job directly, they can apply as "Work by Owner". That route puts code compliance squarely on the homeowner.

Electrical permits are also open to homeowners doing their own electrical work in their own home.

No construction can begin until the permit is issued.

Permit and inspection process, step by step

Once the scope is locked in, the next move is the permit application and inspection plan. Start with the full scope of work. If the project changes walls or shifts the layout, you’ll need two sets of scaled drawings that show dimensions, openings, and structural details. If plumbing or electrical is changing, trade plans are usually part of the package too.

Applications can be submitted in person or by email to the Department of Infrastructure and Development. In Wicomico County, permit processing usually takes 10 to 14 business days.

After the permit is issued and posted on-site, construction can start. From there, inspections happen in stages. Think of it like checkpoints. The county wants to see the work before it gets covered up, not after tile and drywall hide everything.

Inspection Phase When It Happens
Framing Rough-In After electrical, plumbing, and mechanical installations are completed and approved, but before walls are closed
Gas Required if any new gas lines or service are part of the project
Insulation After rough-ins are approved and before final finishes go in
Final After all work is complete and final trade inspections are approved

Final approval happens after the last inspection.

Common Salisbury kitchen remodel scenarios and the right permit path

Cosmetic refresh, mid-level update, and full reconfiguration

Not every kitchen remodel lands in the same permit bucket. A paint-and-flooring update is one thing. Moving plumbing, adding circuits, or taking out a wall is a whole different job.

Use these common project scopes to line up your remodel with the permit path that usually fits. The goal is simple: know what work tends to trigger permits, and know which inspections are likely to show up along the way.

The table below lays out the usual permits and inspection points for each scope.

Scenario comparison table

Scenario Typical Work Included Likely Permits Key Inspection Points
Cosmetic Refresh Cosmetic only: painting, flooring, backsplash, same-location cabinet/counter replacement, like-for-like appliance swaps None (usually permit-free) N/A
Mid-Level Update Plumbing/electrical changes: moving the sink and adding new electrical circuits, dishwasher relocation or new dishwasher line Plumbing, Electrical Rough-in (plumbing/electrical), Final
Full Reconfiguration Structural/system changes: wall removal, island with power, gas range installation, new exterior door Building, Electrical, Plumbing, Gas, Mechanical Framing, Gas pressure test, Rough-in, Final

FAQs

How do I know if my home is in the city or county permit area?

Check first whether your property is inside Salisbury city limits or in unincorporated Wicomico County. That one detail decides where the permit goes.

Within the city, permits are handled by the City of Salisbury Department of Infrastructure and Development. Outside city limits, Wicomico County handles permits instead.

Not sure which side your property falls on? Look at the property’s legal description, or call to confirm:

A two-minute phone call here can save you from filing with the wrong office.

What happens if I start my kitchen remodel without a permit?

If your kitchen remodel in Salisbury, MD, needs a permit and work starts without one, the fallout can get expensive fast.

The City may issue a Stop Work Order and force the job to pause on the spot. That usually means delays, rescheduling, and extra labor costs you didn't plan for. On top of that, permit fees can go up once the work has already started.

There's more. You could face daily fines, and the City may require unpermitted work to be removed or redone at your expense. If walls are closed up before inspection, parts of the project may need to be opened back up so the work can be checked.

This doesn't always end when construction ends, either. Unpermitted work can create problems during a future home sale, especially when buyers, agents, or inspectors start asking questions. It may also lead to insurance claim denials if a later issue ties back to work that wasn't approved.

Do I need separate permits for electrical, plumbing, and gas work?

Yes. If your kitchen remodel includes electrical, plumbing, or gas work, you’ll usually need separate permits for each of those systems.

In Salisbury and Wicomico County, work like moving plumbing, adding a gas line, or installing new electrical outlets often requires permits and inspections. Those permits are commonly filed as separate applications, along with any main building permit tied to structural changes.
